Ship Design and Construction

Ship design and construction stand as one of the most sophisticated, multidisciplinary, and capital-intensive engineering disciplines in the world. Unlike mass-produced automobiles or aircraft, every commercial vessel is a unique, purpose-built machine engineered to operate reliably for 25 to 40 years in some of the planet’s harshest environments—corrosive saltwater, extreme waves, sub-zero Arctic conditions, or tropical humidity.

The process integrates naval architecture, structural engineering, mechanical systems, electrical power distribution, hydrodynamics, materials science, regulatory compliance, project management, and global supply chain logistics. A single large vessel may involve over 100,000 individual components, 50,000 engineering drawings, 10,000 tons of steel, and a workforce of 5,000+ specialists across multiple continents.

This guide examines every phase of ship design and construction in granular detail—conceptualization, preliminary and detailed engineering, production planning, modular fabrication, hull assembly, outfitting, launching, sea trials, regulatory frameworks, vessel classifications, construction economics, global shipyard capabilities, sustainability mandates, and emerging technologies such as autonomous navigation and zero-emission propulsion. Technical specifications, cost breakdowns, performance metrics, classification society requirements, and real-world examples are included throughout.

The Ship Design Spiral

Ship design is not linear—it is a design spiral, where each revolution refines the vessel with increasing precision. The spiral begins broad and conceptual, then narrows into detailed production-ready documentation. At every stage, naval architects, marine engineers, classification societies, shipowners, and flag states provide input, forcing iterations until technical feasibility, economic viability, regulatory compliance, and operational efficiency converge.

The Ship Design Spiral

Stage 1: Concept Design – Defining the Vessel’s DNA

Client-Driven Mission Requirements

The journey begins when a shipowner, operator, or charterer issues a Request for Proposal (RFP) or Shipbuilding Specification. This document is the vessel’s genetic code.

Example: Bulk Carrier RFP

ParameterSpecification
Deadweight82,000 DWT
CargoCoal, grain, iron ore
Service Speed14.0 knots @ 85% MCR
Range25,000 nautical miles
Ice Class1C (Baltic winter)
Crew22 persons
FuelVLSFO + scrubber
Port RestrictionsPanama Canal (New Panamax)

Hull Form Generation

Using parametric design software (e.g., NAPA, Maxsurf, Paramarine), naval architects generate lines plans—mathematical curves defining the hull’s shape.

Key non-dimensional coefficients:

  • Block Coefficient (Cb) = ∇ / (LPP × B × T) → 0.80–0.85 for full-form bulkers
  • Prismatic Coefficient (Cp) = ∇ / (Am × LPP) → 0.82–0.87
  • Waterplane Coefficient (Cwp) → 0.88–0.92

A lower Cb reduces resistance at high speeds but sacrifices cargo volume. Optimization uses genetic algorithms to minimize total resistance (Rt) across a speed range.

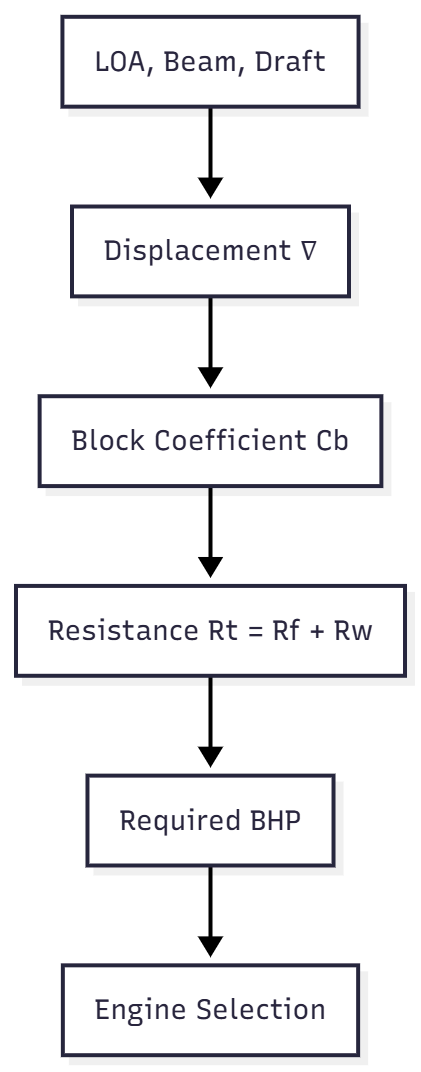

Defining the Vessel’s DNA

Preliminary General Arrangement (GA)

The GA is a 2D top/side/profile view showing:

  • Cargo holds (5–7 for Handymax)
  • Engine room aft
  • Accommodation superstructure
  • Double bottom height (≥ B/20 or 760 mm per SOLAS)
  • Collision bulkhead at 0.05L–0.08L from FP

Techno-Economic Analysis

A Required Freight Rate (RFR) model compares:

  • Capital Expenditure (CAPEX): $35M build cost
  • Operating Expenditure (OPEX): $6,500/day (fuel, crew, insurance)
  • Revenue: $25,000/day at Baltic Dry Index (BDI) 1,500

If RFR > market rate → redesign (e.g., reduce speed to 13.5 knots, save 12% fuel).

Stage 2: Preliminary (Basic) Design – Locking the Architecture

Hydrostatics and Stability

Using intact and damage stability criteria (IMO Res. A.749, SOLAS Ch. II-1):

CriterionRequirement
Area under GZ curve (0°–30°)≥ 0.055 m·rad
Area (0°–40° or flood)≥ 0.09 m·rad
Area (30°–40°)≥ 0.03 m·rad
Max GZ≥ 0.20 m at ≥ 25°
Angle of max GZ≥ 25°
GM₀≥ 0.15 m

Inclining experiment post-launch verifies lightship weight and KG.

Resistance and Powering

Using Holtrop-Mennen regression or CFD (STAR-CCM+, OpenFOAM):

Speed (knots)Total Resistance (kN)Effective Power (kW)
12.04205,300
14.06809,900
15.088013,800

Sea margin: 15%
Engine margin: 10%
Transmission efficiency: 98%
Brake Horsepower (BHP) = 14,500 kW → MAN 6S60ME-C10.2 (16,800 kW MCR)

Structural Design

Midship section defines:

  • Double bottom height
  • Frame spacing (800–900 mm)
  • Plate thickness (12–22 mm)
  • Longitudinals (bulb flats HP 260×10)

Global strength via IACS Common Structural Rules (CSR):

  • Bending moment: M = ±0.1 × L² × B × (Cb + 0.7) × 10⁻³ kNm
  • Shear force: F = ±0.025 × L × B × (Cb + 0.7) × 10⁻¹ kN

Stage 3: Detailed Design – Production-Ready Engineering

3D Product Model (Digital Twin)

Using AVEVA Marine, Siemens NX, or Cadmatic:

  • Full hull, structure, outfitting in one model
  • Clash detection (piping vs. structure)
  • Weight and CG tracking (±1% accuracy)

Finite Element Analysis (FEA)

Global model: Entire hull, 1.2 million elements
Local models: Hatch corners, bilge keel roots

Load CaseStress (MPa)Allowable (355 MPa steel)
Sagging220280
Hogging210280
Torsion180250

Systems Engineering

Piping

  • 12,000+ pipes
  • Materials: Carbon steel (Sch 40), stainless (316L), CuNi
  • Pressure ratings: 10–150 bar
  • Isometric drawings with BOM

Electrical

  • Main switchboard: 6.6 kV, 3,000 A
  • Emergency generator: 750 kW
  • Cable trays: 45 km total
  • Load analysis: 8.5 MW peak

HVAC

  • 600 tons refrigeration
  • AHUs for accommodation, engine room
  • CO₂ fire suppression in holds

Classification Society Approval

Drawing TypeSubmitted ToApproval Time
Lines PlanDNV2 weeks
Midship SectionABS3 weeks
Stability BookletLR4 weeks
FEA ReportBV6 weeks

Stage 4: Production Design – From Drawing to Steel

Steel Material Specification

GradeYield StrengthApplication
AH36355 MPaShell, strength deck
DH36355 MPaIce-strengthened areas
EH36355 MPaHigh-stress zones
Mild Steel235 MPaInternal bulkheads

CNC Nesting and Cutting

AutoNEST optimizes plate usage:

  • 92% material utilization
  • 8% scrap (recycled)
  • Cutting speed: 800 mm/min (plasma)

Block Construction Workflow

Block Construction Workflow

Block Example: Engine Room Double Bottom

  • Weight: 420 tons
  • Dimensions: 24m × 32m × 8m
  • Pre-installed: Main engine beds, pump foundations, 1,200 m piping

Ship Construction Phases

1. Keel Laying

  • First block placed on keel blocks
  • Official construction start (contract milestone)
  • Coin ceremony (tradition)

2. Block Erection

  • 50–80 grand blocks
  • 1,600-ton gantry cranes
  • Weld shrinkage allowance: 1 mm/m
  • Alignment tolerance: ±5 mm

3. Pre-Launch Outfitting

System% Installed Pre-Launch
Piping70%
Electrical65%
Machinery90%
HVAC60%

4. Launching Methods

MethodApplicabilityExample
SlipwaySmall–medium shipsTraditional
ShipliftUp to 25,000 tonsSyncrolift
Float-OutMega-shipsIcon-class in dry dock
Sideways LaunchSpace-constrainedEuropean yards

Launch Calculations:

  • Declivity: 1:20
  • Triggering force: 1,200 tons
  • Sliding velocity: 0.5 m/s
  • Stopping distance: 120 m

Testing and Commissioning

Dock Trials

  • Main engine turning gear test
  • Generator load bank (100% for 4 hrs)
  • Bilge pump capacity: 2 × 150 m³/h
  • Steering gear: 28° in 28 sec (SOLAS)

Harbor Trials

  • Anchor windlass: 3 shackles in 3 min
  • Lifeboat lowering: 60 sec
  • Fire pump: 1,200 m³/h at 12 bar

Sea Trials Program

TestDurationMetrics
Speed Trial6 hrs14.8 knots @ 85% MCR
Crash Stop1 hr11.2 ship lengths
Zigzag30 min12° overshoot
Turning Circle20 min3.8 ship lengths
Endurance12 hrsVibration < 8 mm/s

Noise Levels (IMO Code on Noise):

  • Cabins: ≤ 55 dB(A)
  • Bridge: ≤ 65 dB(A)
  • Engine Room: ≤ 110 dB(A)

Regulatory Framework

SOLAS (Safety of Life at Sea)

Key Chapters:

  • II-1: Construction, stability, machinery
  • II-2: Fire protection, detection, extinction
  • III: Life-saving appliances
  • V: Navigation safety
  • XI-2: Enhanced surveys (ESP for bulkers)

2024 Amendments:

  • GMDSS: Iridium recognized alongside Inmarsat
  • Mooring: Line design factor ≥ 1.5, LSA mandatory
  • Watertight Doors: Power-operated, local + remote control
  • Free-fall Lifeboats: No 5-knot launch test required

MARPOL (Pollution Prevention)

AnnexFocusKey Limit
IOil15 ppm discharge
IVSewage25m from shore
VGarbageZero plastic
VIAir0.5% sulfur (global), EEDI Phase 3

EEXI (Energy Efficiency Existing Ship Index):

  • Required Attained EEXI ≤ Required EEXI
  • Remedies: Engine power limitation (EPL), shaft generators, bulbous bow retrofit

Load Line Convention

  • Freeboard calculation: Tabular + corrections
  • Type A (tankers): Full subdivision
  • Type B (dry cargo): Reduced freeboard

Vessel Types and Classifications

Bulk Carriers

ClassDWTLOABeamDraftHoldsHatch Size
Handysize15–39k130–160m23–28m9–10m515×12m
Handymax40–50k170–190m30m11m518×14m
Supramax50–60k190–200m32m12.5m520×16m
Panamax60–80k225m32.26m14m722×18m
Post-Panamax80–110k250m40m14.5m725×20m
Capesize160–210k290–310m45–50m18m930×25m

Price Range:

  • Handysize: $24–28M
  • Capesize: $58–65M

Tankers

TypeDWTCargo SystemTank CoatingPrice
Product10–160kSegregated ballastEpoxy$40–90M
Aframax80–120kCOW, IGSEpoxy$55–70M
Suezmax120–200kDouble hullEpoxy$70–85M
VLCC280–320kSBT, IGSEpoxy$95–110M
ULCC>320kRareEpoxy$120M+

Chemical Tankers:

  • IMO Type 1: Full double hull, deepwell pumps
  • Cargo heating: Steam coils to 80°C
  • Nitrogen blanketing for IMO Type 2

Container Ships

ClassTEULOABeamRowsPrice
Feeder<3,000<200m<30m12$20–40M
Panamax5,000294m32.2m13$60M
Post-Panamax8–14k350m42m18$100–140M
ULCV18–24k400m61m24$180–220M

Example: MSC Irina (24,346 TEU)

  • Builder: Yangzijiang Shipbuilding
  • Engine: WinGD 11X92DF (dual-fuel LNG)
  • Bunker capacity: 22,000 m³ LNG
  • Delivery: 2023

Global Shipbuilding Industry

Market Share (Newbuild Tonnage)

CountryShareKey Players
South Korea40%Hyundai, Samsung, Daewoo
China35%CSSC, CSIC, Hudong-Zhonghua
Japan15%Imabari, Oshima
Europe5%Fincantieri, Damen
Others5%Vietnam, Philippines

South Korean “Big Three”

YardSpecialtyAnnual Capacity
Hyundai Heavy (Ulsan)LNG, VLCC40 vessels
Samsung (Geoje)ULCV, drillships35 vessels
Daewoo (Okpo)LNG, FPSO30 vessels

Automation Level:

  • Robotic welding: 80%
  • Digital twin integration: 100%
  • Build time: 12 months (VLCC)

Cost Breakdown and Economics

Cost Element% of Total60k DWT Bulker ($36M)300k DWT VLCC ($105M)
Steel20%$7.2M$21M
Labor30%$10.8M$31.5M
Machinery40%$14.4M (engine $9M)$42M (engine $25M)
Design5%$1.8M$5.25M
Outfitting5%$1.8M$5.25M

Daily Operating Cost:

  • Handysize: $5,500
  • Capesize: $8,000
  • VLCC: $12,000

Charter Rates (2024 avg):

  • Capesize: $25,000/day
  • VLCC: $40,000/day

Sustainability and Future Technologies

Energy Efficiency Design Index (EEDI)

Phase 3 (2025+):

  • Bulk carriers: 30% reduction vs. 2013 baseline
  • Tankers: 35% reduction

Alternative Fuels

FuelEnergy DensityInfrastructureMaturity
LNG48 MJ/kgGrowingCommercial
Ammonia19 MJ/kgEmergingPilot (2028)
Hydrogen120 MJ/kgLimitedR&D
Methanol20 MJ/kgAvailableDual-fuel engines

Example: Icon of the Seas (LNG-powered cruise ship)

  • 6 × Wärtsilä 14V46DF
  • 100 tons LNG/day
  • 40% lower CO₂ vs. HFO

Autonomous Ships

Yara Birkeland:

  • 120 TEU
  • Battery-electric
  • Fully autonomous by 2026
  • Route: Herøya to Brevik (7 nm)

Project Management and Quality Control

Critical Path Method (CPM)

MilestoneDuration from Keel
Keel LayingDay 0
LaunchDay 240
Sea TrialsDay 300
DeliveryDay 330

Quality Assurance

  • ISO 9001 certified
  • NDT: 100% UT on butt welds, 20% MT on fillets
  • Dimensional Control: Laser scanning, ±3 mm tolerance
  • Warranty Claims: <1% of contract value

Frequently Asked Questions

What are the main stages of ship design and construction?

Ship design and construction follow a structured spiral: Concept Design (defining mission requirements and hull form), Preliminary (Basic) Design (general arrangement, stability, and powering), Detailed Design (3D modeling, FEA, systems integration), and Production Design (fabrication drawings and block assembly plans). After design, construction includes steel cutting, block fabrication, hull erection, outfitting, launching, and sea trials before delivery.

How long does it take to build a large commercial ship?

Construction time varies by type and yard efficiency:
Handysize bulker (30,000 DWT): 6–9 months
Panamax container ship (5,000 TEU): 12–15 months
VLCC tanker (300,000 DWT): 12–18 months
Ultra Large Container Vessel (24,000 TEU): 18–24 months Modern Korean and Chinese yards using block construction and automation achieve the fastest timelines.

What is block construction in modern shipbuilding?

Block construction is a modular method where the ship is built in large prefabricated sections (blocks) weighing 300–600 tons. Each block is fully outfitted with piping, cables, and equipment before being transported to the dry dock for final assembly. This reduces on-site work, improves quality control, cuts construction time by up to 40%, and allows year-round indoor fabrication.

What regulations govern ship design and safety?

The International Convention for the Safety of Life at Sea (SOLAS) is the primary treaty, covering construction, stability, fire protection, and life-saving appliances. Other key regulations include MARPOL (pollution prevention), Load Line Convention, and IACS Common Structural Rules (CSR). Classification societies (DNV, ABS, Lloyd’s) approve designs and issue certificates. Port State Control enforces compliance globally.

How much does it cost to build a ship in 2025?

Costs depend on size, type, and technology:
Handysize bulker (35,000 DWT): $24–28 million
Supramax bulker (58,000 DWT): $32–36 million
VLCC tanker (310,000 DWT): $95–110 million
ULCV container ship (24,000 TEU): $180–220 million Steel (~20%), labor (~30%), and machinery (~40%) are the largest cost components. Dual-fuel (LNG) or scrubber-fitted ships add 10–20% to the price.

Conclusion

Ship design and construction represent the pinnacle of human engineering ingenuity—blending centuries-old naval architecture principles with cutting-edge digital tools, robotics, and sustainable technologies. From the first lines plan sketched in NAPA to the final sea trial where a 300,000-ton behemoth achieves 15 knots under its own power, every step is a testament to precision, collaboration, and foresight.

The vessels built today will trade for decades, navigating evolving regulations, fuel transitions, and digital transformation. Whether a modest Handysize bulker carrying grain from Ukraine or a 24,000 TEU megaship linking Shanghai to Rotterdam, each ship is a floating city of steel, systems, and human expertise.

The global fleet—over 100,000 vessels—forms the backbone of world trade, carrying 11 billion tons of cargo annually. Behind every voyage lies a design and construction story of relentless optimization, regulatory rigor, and industrial might.

This article serves as the definitive reference for students, engineers, shipowners, and maritime professionals seeking to understand the full lifecycle of modern ship design and construction.

Happy Boating!

Share Ship Design and Construction with your friends and leave a comment below with your thoughts.

Read Ship Surveys and Inspections until we meet in the next article.

Similar Posts

Leave a Reply

Your email address will not be published. Required fields are marked *
